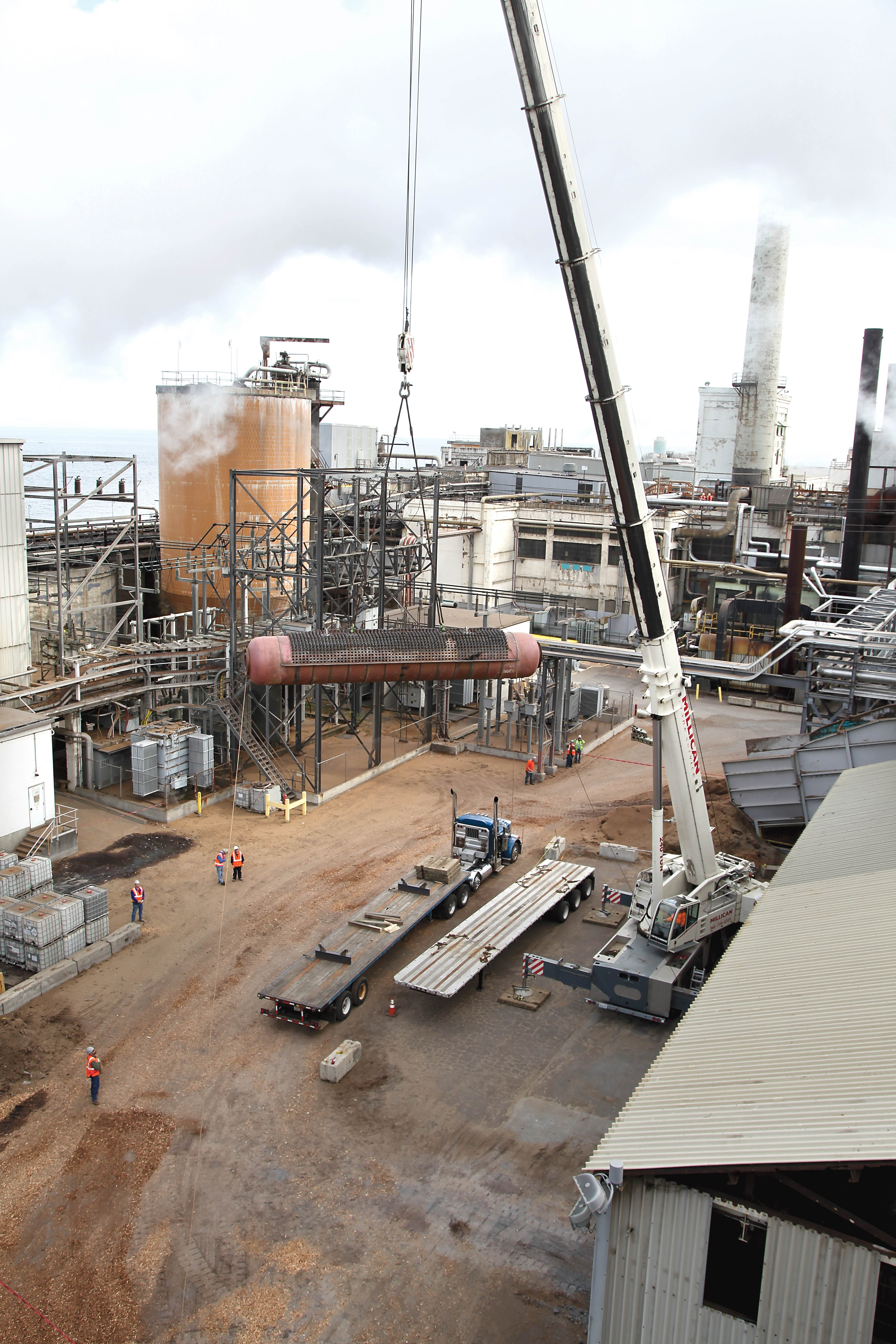

A faulty boiler that delayed Nippon Paper Industries’ $85 million biomass cogeneration plant operations is carried by a crane earlier this year. — Nippon Paper Industries USA photo

A faulty boiler that delayed Nippon Paper Industries’ $85 million biomass cogeneration plant operations is carried by a crane earlier this year. — Nippon Paper Industries USA photo

Nippon biomass cogeneration plant targets Nov. 1 start

PORT ANGELES — Work could wrap up in the next several weeks on Nippon Paper Industries USA’s long-stalled biomass cogeneration plant.

The expectation is that it will be up and running full bore by Nov. 1.

“We hope to beat that,” Steve Johnson, mill manager, said last week. “We have several weeks of work left.”

ADVERTISEMENT
0 seconds of 0 secondsVolume 0%
Press shift question mark to access a list of keyboard shortcuts
00:00
00:00
00:00


Tests on the new boiler mud drum that was installed in early September will result in a steam plume expected to issue from the plant at Ediz Hook later this week, Johnson said.

If the Nov. 1 finish date holds, the cogeneration plant will be fully operational nearly a year after the project was slated to begin producing steam for the mill and 20 megawatts of electricity for the mill and for sale to buyers of green energy.

The Tokyo-based company had made agreements with buyers who wanted to purchase the cogeneration plant’s electricity.

Nippon has made good on the commitments by purchasing electricity on its own and reselling it to those buyers.

“We did what was right by our customers,” Johnson said.

“We made a commitment, and we honored it.”

The project, expected to exceed $85 million, was dedicated during a ceremony at the papermaking plant Nov. 1, 2013, with the expectation is would be operational later

that month.

But cracks were discovered in the plant boiler’s mud drum, a 30-foot, 25-ton pressurized vessel that collects solids from the boiler drum, and the plant has never operated at capacity.

The mud drum and 40,000 feet of tubing have since been replaced in repairs that have boosted the cost of the project, which had been estimated at $71 million in 2010 and rose 20 percent to $85 million by 2013.

Johnson would not disclose the current cost but said it will be “comfortably” under $90 million.

The project upgrades the existing cogeneration plant, which has an antiquated boiler that uses biomass — woody debris such as forest slash and peeled bark — to produce only steam for the plant and is in use until the new boiler works.

Nippon, which produces telephone book paper and newsprint for the Peninsula Daily News and the weekly Sequim Gazette and Forks Forum, continues to employ about 200 workers and operate 24 hours a day, seven days a week, Johnson said.

“The support out of Tokyo and senior management has been outstanding,” he added.

“Certainly they’re disappointed in the delays, don’t get me wrong, but their support has been strong.”

Problems with the biomass plant first shut it down completely in February.

Nippon and Covington, La.-based FSE Energy, the primary contractor for the cogeneration plant project, expect to undergo mediation to determine who will cover repair and replacement costs, Johnson said.

“We’re still waiting on the contractor to get back to us, and we can meet in mediation,” he said.

Earlier this summer, a hole was cut in the side of the boiler and the cracked mud drum rolled out on a steel jig before being placed on the ground.

The new mud drum “went in exactly the same way” the old component came out, Johnson said.

On Sept. 8, the boiler was filled with water, pressure was applied, and their were no leaks.

The boiler can produce 225,000 pounds of steam.

“There are still many weeks to go, but it was a big milestone, if you will,” Johnson said.

The boiler wall was replaced the weekend of Sept. 13, and the internal surface was chemically cleaned by Friday.

Port Townsend Paper Corp. earlier this year abandoned a much-disputed $54 million project to upgrade its own cogeneration plant that would have generated 24 megawatts.

Both projects survived numerous environmental challenges.

But those challenges slowed down the Port Townsend project and, combined with a strong market for cheap natural gas, were a factor in dooming it, company President Roger Hagan told Peninsula Daily News earlier this year.

The cracked mud drum and 1,600 steam tubes from Nippon’s cogeneration project will remain in the mill’s parking lot for the time being.

“We’re obviously saving those for arbitration,” Johnson said.

________

Senior Staff Writer Paul Gottlieb can be reached at 360-452-2345, ext. 5060, or at pgottlieb@peninsuladailynews.com.

More in News

From left to right, Northwest School of Wooden Boatbuilding students Krystol Pasecznyk and Scott McNair sand a Prothero Sloop with Sean Koomen, the school’s boat building program director. Koomen said the sanding would take one person a few days. He said the plan is to have 12 people sand it together, which will take a few hours. (Elijah Sussman/Peninsula Daily News)
Wooden boatbuilding school building ‘Twin Boats’

Students using traditional and cold-moulding construction techniques

Prevailing wage by trade across multiple counties in Washington state.
Prevailing wage s are driving up housing

Administrative burden may decrease competition

North Olympic Library System
Rendering of the new Sequim Library, which is currently under construction.
Library system board recognizes top donors

Naming opportunities still available

Port of Port Angeles approves roof rehab projects

McKinley Paper Company moves out of Marine Drive warehouse

Drug takeback day set across Peninsula on Saturday

Law enforcement agencies across the North Olympic Peninsula are poised to take… Continue reading

Public meeting set to meet administrator candidates

Jefferson County will host a public meeting at 5… Continue reading

Interfund loan to pay for Port Townsend meter replacement

City will repay over four years; work likely this winter

Artists to create murals for festival

Five pieces of art to be commissioned for downtown Port Angeles

Clallam assessor’s office to extend reduced hours

The Clallam County assessor’s office is continuing its reduction… Continue reading

Girders to be placed Thursday night

Contractor crews will place four 100-foot bridge girders over a… Continue reading

Cameras to check recycling contents in new program

Olympic Disposal will deploy a system of computerized cameras to… Continue reading

Port Angeles Fire Department responds to a residential structure fire on West 8th Street in Port Angeles. (Jay Cline)
Police: Woman arrested in arson investigation

Niece of displaced family allegedly said house was ‘possessed’
